Hindi and Farsi, backed by an international team of experts.

Consequently, the high risk project at Sohar, which

achieved over 2.505 million safe man-hours, resulted in no

delays and no medical treatment.

The most recent turnaround took two months and

involved full access to the site, the opening of vessels,

replacing equipment, repairing pipelines and even carrying

out general maintenance tasks. The project witnessed

4288 pieces of equipment being maintained, which

included boilers, columns, pumps, piping, valves,

exchangers, vessels and instruments. The sheer volume of

this task could easily have ended in accidents, costly delays

and plant damage if not handled with the appropriate care.

For this reason, the company passed the management of

the project to RRC Middle East.

RRC was tasked with conducting the project’s health

and safety programme, during which it trained the

7223 contractors and staff at the refinery. RRC, which had

already managed the safety aspects of the turnaround for

ORPIC on two previous occasions, in 2009 and 2013,

deployed its team of Middle Eastern oil and gas HSE

practitioners.

The 2013 turnaround saw RRC manage the health and

safety aspects onsite for 46 days, during which time it

provided 10 competent oil and gas HSE practitioners to

cover the vast areas and numerous maintenance activities

required. There were over 3500 workers, all of whom

performed a variety of extremely high risk tasks, so RRC had

to provide safety induction training for the entire workforce.

The RRC team also had to conduct regular safety inspections

and spot checks to ensure that all safety rules were adhered

to and that the equipment was fully operational; risk-assess

work activities before issuing permits to work; and enforce

adherence to personal protective equipment (PPE)

requirements. The team was able to help ORPIC turn around

its site with no incidents and minimum loss to productivity.

The RRC team provided field management of all high

risk activities, starting from the planning phase through to

project execution, and the restarting of oil production at

the plant. During this process, RRC also trained all the

ORPIC contractors to work safely whilst the plant was in its

shutdown period. During its busiest periods, there were up

to 5737 contractor personnel on site at any one time.

As with any health and safety shutdown, safe working

practices were vital, especially as the contractors were

working on the refinery’s critical process areas containing

highly flammable hydrocarbons. This requires extra

knowledge and precautions necessary for working in a

potentially explosive atmosphere. It is also a legal

requirement to train workers in basic firefighting when

entering such a workplace, as well as those who are

working in a confined space, at height, or who have

responsibility for approving or receiving work permits.

In addition, equipment and process units designed and

built to run at normal conditions to process hydrocarbons,

such as pipes, vessels, pumps and exchangers, were opened

during the turnaround. As a result, workers enter areas that

are not designed for work and may contain specific hazards

that could be life threatening if the correct precautions are

not taken.

Training and education

As part of its training provision, RRC’s team examined the

role each worker and contractor had to undertake during

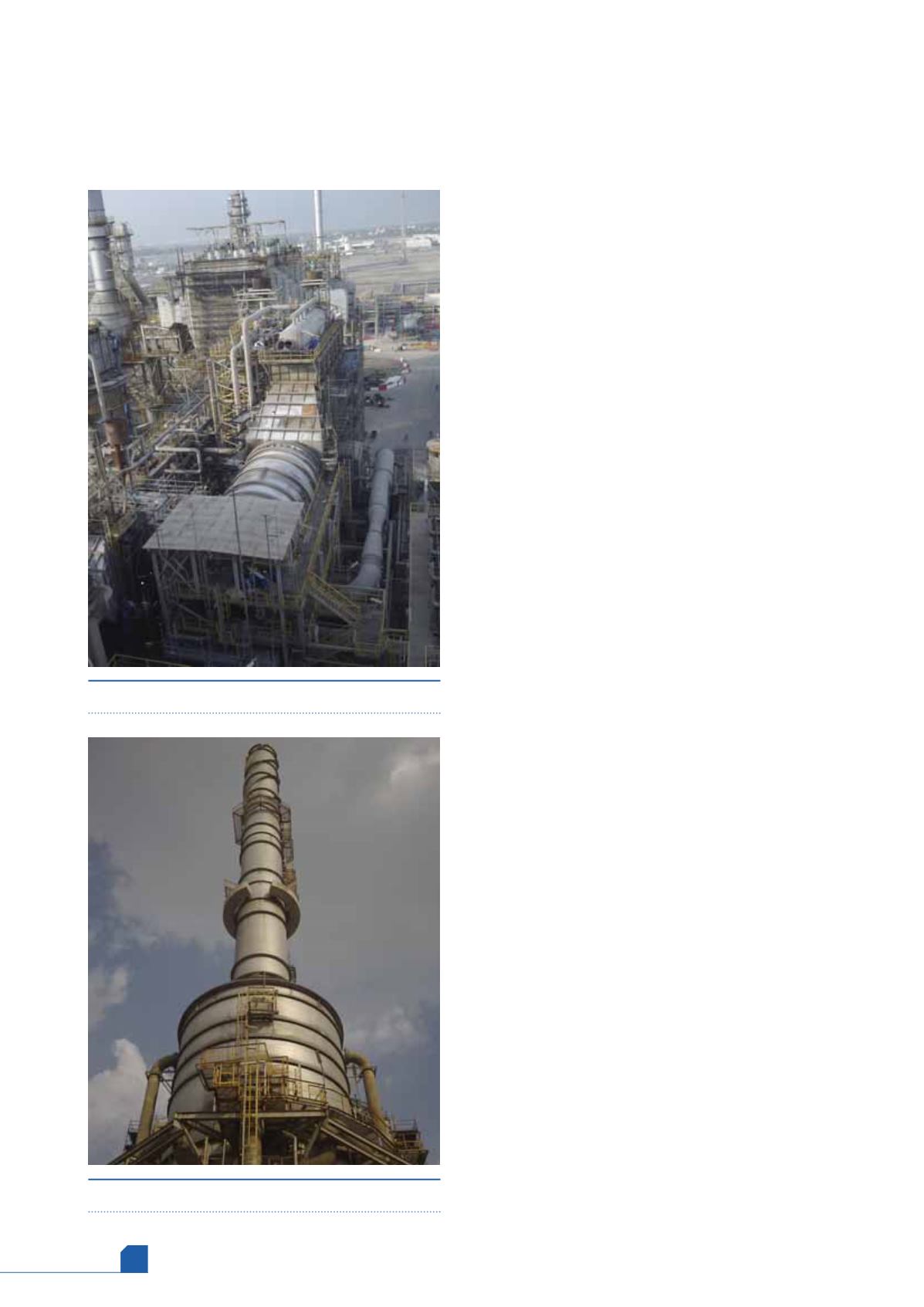

Figure 1.
